Introducing Kilimanjaro’s Machame Route
Machame is a camping route on the southern side of Mount Kilimanjaro. It begins in rainforest near Machame Gate and climbs through moorland towards the Shira area. Higher up, the trail passes Lava Tower and reaches Barranco before crossing the Barranco Wall. From there, climbers continue towards Barafu for the summit attempt and descend by the Mweka trail.
Most visitors compare six-day and seven-day Machame schedules. The important difference is how the higher mountain days are divided. A seven-day itinerary commonly spends a night at Karanga before Barafu, while a shorter version may combine those stages. Both require fitness, warm gear and attention to altitude symptoms. A mountain guide may change the plan when conditions or a climber's health demands it.
Capable Africa Tours arranges the guide and crew, camping logistics, park arrangements and the services in your climbing booking. We can explain the camp sequence and what belongs in the quoted price before you decide which duration fits.
Our seven-day Machame itinerary describes the extra Karanga night and the subsequent summit-day descent. If sleeping in huts is more important to you than the southern circuit scenery, see the Marangu hut route for a different route arrangement.

What is different about Machame?
The Barranco Wall can look intimidating in photographs. It has steep rocky steps where you sometimes use your hands for balance, but it is part of the standard trekking line and not normally a technical roped climb. Your guide sets the pace and checks how the group is handling the altitude.
A guide, cooks and porters support the climb, while each trekker is responsible for a sensible personal pace. You need adequate sleeping equipment, warm layers and waterproof clothing even outside the wettest months.
Six or seven days: choose for acclimatization, not speed
The six- and seven-day Machame versions often use the same lower route, so the important difference appears higher up. On a seven-day plan, climbers commonly stay at Karanga after Barranco and walk to Barafu the next day. A shorter schedule may combine those stages. That extra mountain night does not guarantee the summit, but it changes the daily effort and gives another opportunity to adjust to the altitude. Decide based on your fitness and available days, not price alone.
If you are flying in from sea level and have never trekked high, discuss acclimatization carefully. There is no trustworthy summit-percentage promise for any individual guest.
Compare your options
| Option | Route rhythm | Important consideration |
|---|---|---|
| 6-day Machame | Faster progression after Barranco | Less time for acclimatization |
| 7-day Machame | Separate Karanga overnight on common program | Additional day and cost, more gradual schedule |

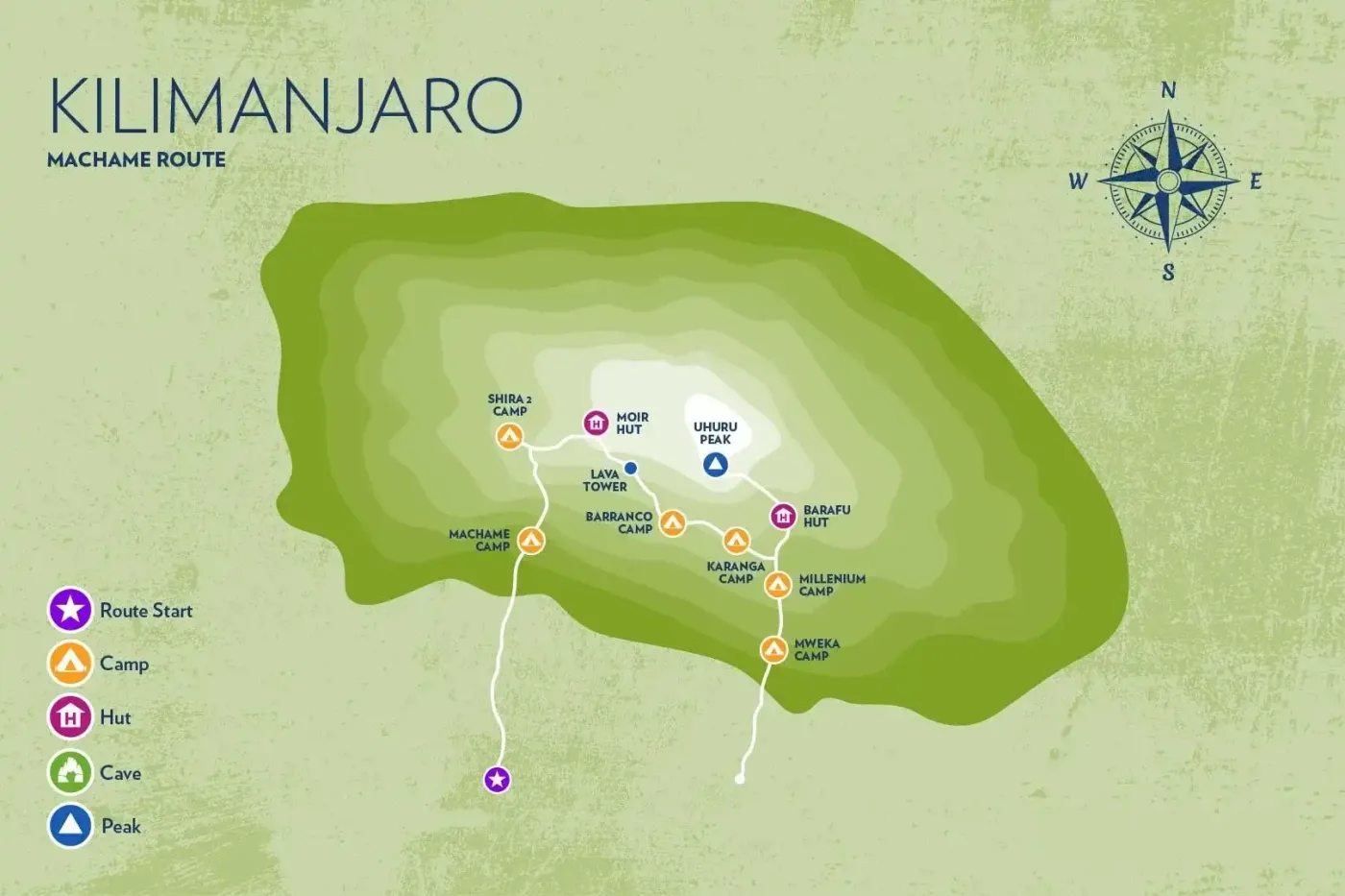

A common seven-day Machame trekking itinerary
These are mountain trekking days only; arrival and hotel nights are arranged separately.
Day 1 — Machame Gate to Machame Camp
Register at the gate and hike through the montane forest to Machame Camp. Rain and mud are possible. Forest mud can be slippery, especially after rain. Start steadily and keep the items you need during the walk in your daypack instead of with the porter-carried luggage.
Day 2 — Machame Camp to Shira Camp
Continue onto the Shira Plateau through open moorland. The air becomes thinner; a steady pace matters. The change from forest to open ground brings stronger sun and cooler wind. Pay attention to your energy and breathing as the campsite altitude increases.
Day 3 — Shira to Barranco via Lava Tower
Walk higher toward the Lava Tower area and descend to Barranco Camp, an itinerary often used to support acclimatization. The climb toward Lava Tower and descent toward Barranco is part of the planned altitude profile. It is not a reason to ignore symptoms: speak to your guide if you feel unwell.
Day 4 — Barranco Wall to Karanga
Cross the Barranco Wall with your guides and continue into the Karanga area. This is a key reason the seven-day route has a different pace. Go at the guide's pace over the rockier passages. At Karanga, the extra night in the seven-day plan can help break up the work before high camp.
Day 5 — Karanga to Barafu
Walk to the high camp, prepare warm layers and rest before the summit departure. Bring together all the clothing and small equipment you will need in the dark. There is a limited window to eat and rest before the summit attempt begins.
Day 6 — Summit attempt and descent to Mweka
Leave during the night, attempt Uhuru Peak when conditions and health permit, then descend for a lower overnight camp. A summit attempt can take many hours, followed by a long descent. The guide's safety judgement matters more than the summit goal, and Mweka is reached only when the team's condition allows.
Day 7 — Mweka Gate
Finish the descent through forest and return to Moshi or your agreed destination. Use the gate day for descent and transfer. Many climbers need time to recover, repack and clean equipment, so a final hotel night in Moshi is practical.

Barranco Wall and summit night are not ordinary walks
Barranco Wall involves steep hands-on scrambling in sections, though it is not a technical rock climb in usual conditions. Summit night begins at very high altitude and is often cold and slow. Guides monitor health, decide on rest and turn-around points and may require a descent if symptoms develop.
Good preparation means hiking with weight, wearing tested footwear and accepting that a safe descent matters more than a summit photo.
What the price should cover
Ask for an itemized breakdown of park and rescue fees, guide and porter support, camping gear, meals, crew wages and transfers. Some quotes include a hotel night before and after climbing; others do not. Sleeping bags, personal clothes, insurance and tips are often separate.
If you are comparing operators, check tent occupancy, group size, porter welfare and the emergency communication process. A lower price alone tells you very little about the support on the mountain.


What is included, and what needs checking?
Included in the proposed package
- Professional registered mountain guides and porter support
- Park fees, camping equipment, meals and transfers as listed
- Mountain support arrangements stated in the booking
Normally separate unless added
- International airfare, visas and medical/travel insurance
- Personal clothing, equipment rental and tips
- Hotel nights and airport transfers unless explicitly included
The mountain-day count, tents and guide-to-trekker arrangement will be explicit in the climbing plan.
Questions worth asking before booking
Does Machame have mountain huts?
No. Machame is normally a tent-based route. The actual result depends on conditions during your visit, so plan the trip around the experience rather than a promised sighting.
Is the seven-day Machame route better?
For many trekkers, the additional acclimatization time is helpful, but personal health and conditions remain decisive.
Can the guide guarantee Uhuru Peak?
No. Altitude, illness and weather may require a descent. The actual result depends on conditions during your visit, so plan the trip around the experience rather than a promised sighting.
What is the hardest day?
Summit night is often the longest and most strenuous part of the climb.
Enquire About Machame Route Climbing
Let us know whether you prefer six or seven trekking days and if camping at altitude is new to you. We can discuss equipment, the Barranco Wall and the recovery night after the descent.
